Skip permit requirements: what homeowners need to know

Understand skip permit requirements for your home project. Learn when you need a permit and how to obtain it easily to avoid fines.

The Extension Works 13 August 2026
Skip permit requirements: what homeowners need to know

Skip permit requirements: what homeowners need to know

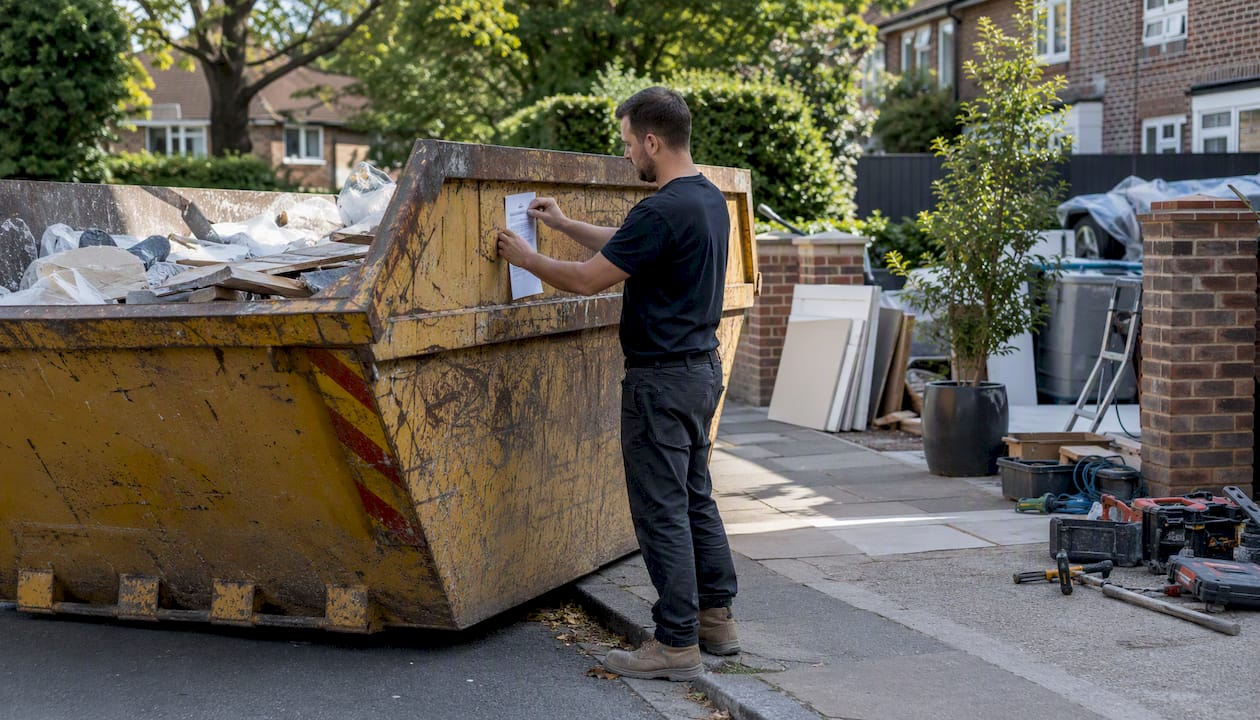

Construction skip with permit notice on street

If any part of a skip sits on the public highway, including the road, pavement, or grass verge, you need a permit before it is delivered. No permit is required when the skip sits entirely on private land, such as a driveway, and does not overhang the highway at all. The legal basis is section 139 of the Highways Act 1980, reinforced by the Builders Skips (Markings) Regulations 1984. Your first step is to contact your chosen skip operator and ask them to apply to the local council. The Gov is the quickest route to your council’s application process.


Key takeaways

A skip on the public highway always requires a permit under the Highways Act 1980, and only a registered operator can apply in most English councils.

Point Details
Highway vs private land A permit is required the moment any part of the skip touches the public highway, including the pavement or verge.
Registered operator only Most councils will only accept applications from registered skip operators, not homeowners directly.
Insurance and credentials Operators must hold at least £5 million public liability insurance and a valid waste carrier registration.
Fees vary widely Council fees range from roughly £12.50 to £260; retrospective permits cost significantly more.
The Extension Works For extension projects requiring skips, The Extension Works manages the full build process, reducing the coordination burden on homeowners.

Your immediate checklist:

  • Confirm whether your placement is on the highway or fully on private land
  • Choose a skip operator registered with your local council
  • Ask the operator to confirm their insurance level and waste carrier number in writing
  • Request that the operator applies for the permit and sends you the permit number before delivery
  • Keep the permit reference and waste transfer notes on site throughout the project

Where to check official guidance and local council fees

  • Gov: the starting point for any England or Wales application, with links to local council pages
  • Skip permit checker (Rent-a-Skip): compares published fees, notice periods, and durations across 208 UK councils
  • Bristol City Council skip permit page: a clear example of how a council publishes fees and retrospective charges
  • Lancashire County Council skip permits: useful for understanding the safety and obstruction criteria councils apply
  • Highways Act 1980, section 139: the statutory text for permit offences and enforcement powers
  • Builders Skips (Markings) Regulations 1984: available via legislation.gov.uk; the definitive reference for marking and lighting requirements

For local fees and notice periods, your council’s highways or licensing team is the most reliable source, particularly for roads with special classifications or active roadworks nearby.


Table of Contents

Skip permit requirements: when do you actually need one?

The simplest test is: does the skip touch the public highway? If yes, a permit is needed. The public highway covers more ground than most people assume.

Scenarios that require a permit:

  • Skip placed at the kerbside on a public road
  • Skip on a grass verge that forms part of the adopted highway
  • Skip on a pavement, even partially
  • Skip on a private driveway that overhangs the pavement

Scenarios that do not require a permit:

  • Skip sitting fully within a private driveway, with no part crossing the boundary onto the pavement or road
  • Skip on a private forecourt or car park
  • Skip inside a gated site or construction compound on private land

A few edge cases catch people out. If your driveway is short and the skip tail overhangs the pavement by even a few centimetres, a permit is required. On narrow streets where skips must be placed kerbside, a permit is always needed, even for a single day. Multi-skip sites on terraced streets almost always need permits for every container on the road.

In most English councils, only the registered skip operator can apply for the permit on the customer’s behalf. Councils commonly refuse applications from unregistered suppliers, so choosing a registered operator is not optional.


How to apply for a skip permit: step-by-step

Only the skip operator can apply in most areas, but you will need to supply some details. Start once you know the exact delivery address, the proposed dates, and which company you are using.

  1. Confirm the operator is registered with the local authority. Ask directly: “Are you registered to apply for highway skip permits in this council area?”
  2. Provide the operator with your site details: full address, proposed placement location (a photo or rough sketch helps), and the dates you need the skip.
  3. The operator submits the application to the council, including their public liability insurance certificate (minimum £5 million, as Lancashire County Council and most other councils require), waste carrier registration, and company details.
  4. Allow the correct notice period. Most councils require 2–5 working days. Some require up to 10 working days for busier roads or classified routes. Submit early.
  5. Pay the permit fee. The operator usually passes this cost to you, either as a line item or included in the skip hire quote.
  6. Receive the permit number in writing before the skip arrives. Keep a copy on site.

If you need a skip urgently and cannot wait for a permit, a wait-and-load service is the legal alternative. The lorry arrives, you load it immediately, and it leaves the same day. No highway time, no permit needed.

Pro Tip: Ask the skip company to email you the permit number and the council’s approval before delivery day. If enforcement officers check the skip and no permit number is displayed or available, the skip can be removed at your cost, regardless of whether the application was submitted.

Homeowners planning a rear extension will often need a skip for several weeks. Aligning the skip delivery with your build programme matters. The guide to building work hours covers how to schedule deliveries within permitted working hours, which affects when the permit period should start.

Hands holding calendar near construction site


Typical permit fees, retrospective charges, and how long permits last

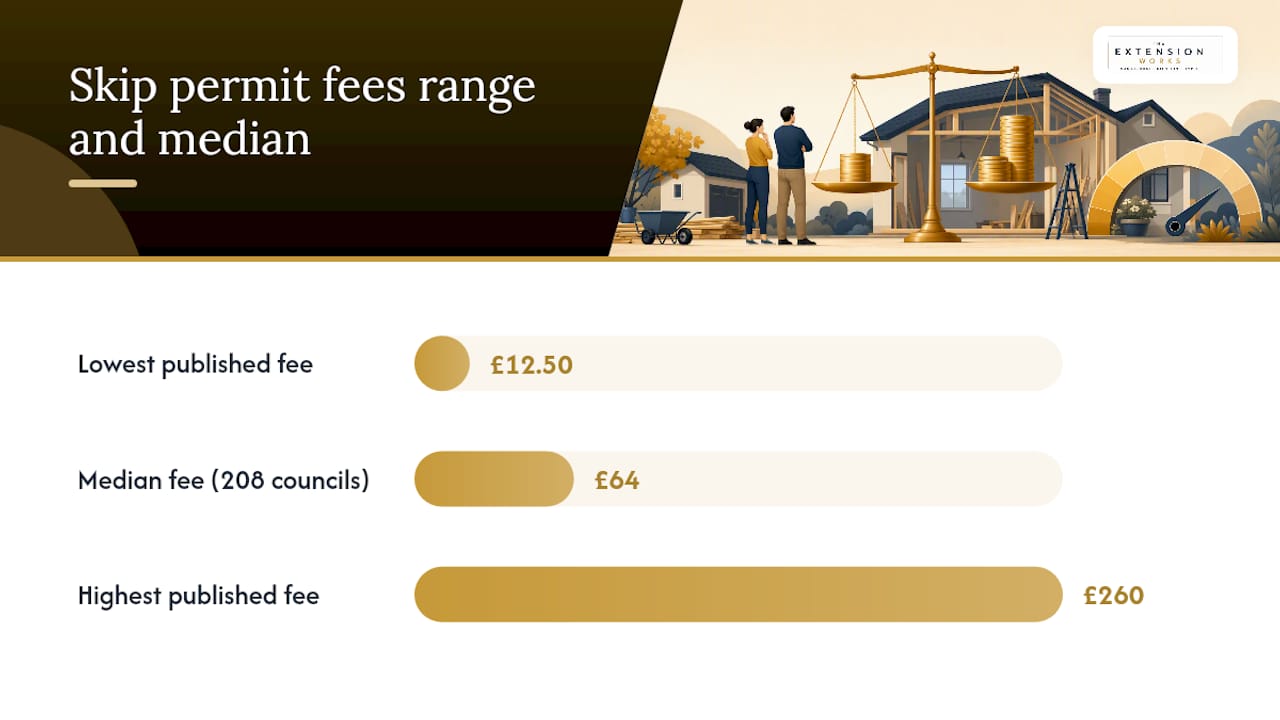

Fees vary considerably. The skip permit checker compiles published fees across 208 UK councils and reports a median fee of around £64, with the range running from roughly £12.50 to £260 depending on the council and permit duration.

Chart of skip permit fee ranges across UK councils

Retrospective permits, applied for after the skip has already been placed, cost significantly more. Bristol’s example of £139 versus £87 illustrates the premium. Some councils will not issue retrospective permits at all and will simply remove the skip and invoice for the removal.

A few practical points on costs:

  • Ask the skip company whether their quote includes the permit fee or lists it separately.
  • Confirm whether the quote assumes a standard or retrospective fee, particularly if delivery dates are tight.
  • Some councils bill per calendar month, meaning a skip placed on the last day of the month incurs a full month’s fee for that day and another full month’s fee for the following month.

Where you may place a skip and the required markings

Councils do not simply grant a permit and leave placement to chance. The Builders Skips (Markings) Regulations 1984 and council guidance from bodies such as North East Lincolnshire Council set out specific physical requirements.

Siting rules operators must follow:

  • Place the skip parallel to and close to the kerb, not angled across the carriageway
  • Maintain a minimum pedestrian clearway of 1.5 metres on the pavement
  • Keep the skip at least 15 metres from any road junction
  • Do not place on school zig-zag markings or within controlled pedestrian crossing zones
  • Do not block drainage gullies, utility covers, or access to apparatus
  • Avoid positioning where visibility for drivers or pedestrians is compromised

Marking and lighting requirements:

  • Reflective markings on all four corners of the skip
  • Vertical hazard warning strips (yellow and black) on the ends facing traffic
  • Two amber lamps lit from dusk to dawn, one at each end facing oncoming traffic
  • The skip operator’s name and telephone number displayed on the skip

If the skip occupies a parking bay or a permit-controlled space, you will likely need a separate parking suspension or dispensation from the council’s parking team, on top of the skip permit itself. These are separate applications and carry their own fees.


Insurance, waste-carrier obligations, and your duty of care

Councils require operators to hold at least £5 million in public liability insurance before a permit is issued. Flintshire County Council specifies that insurance documentation must be current and shown at least five working days before expiry during the permit period.

Documents councils commonly request with an application:

  • Public liability insurance certificate (minimum £5 million)
  • Waste carrier registration certificate (issued by the Environment Agency)
  • Site plan or photograph showing the proposed placement
  • Company registration details and contact information
  • Proposed start and end dates

As a homeowner, your responsibility does not end once the skip is on the road. The waste duty of care requires you to use an authorised carrier and to obtain a waste transfer note for every load removed. If a skip company disposes of your waste illegally, you can be held partly responsible.

Pro Tip: Before the skip arrives, ask the operator for their Environment Agency waste carrier registration number and check it on the public register at gov.uk. Also request a waste transfer note in writing once the skip is collected. Keep it for at least two years.

For renovation projects, your home insurance may also be affected during building works. The guide to home insurance during renovation explains what to check with your insurer before work begins.


What happens if a skip is placed without a permit

Placing a skip on the public highway without authorisation is a criminal offence under section 139 of the Highways Act 1980. Councils and police can act quickly.

Possible consequences:

  • Fixed-penalty notice issued to the skip owner or operator
  • Fine of up to £1,000 on prosecution
  • Council removal of the skip, with all costs recharged to the skip owner
  • Requirement to obtain a retrospective permit at a higher fee, where the council allows it
  • Potential prosecution in persistent or serious cases
  • Invoice for any damage caused to the highway surface

If you find an unauthorised skip placed outside your property by a third party, photograph it immediately, note any company name or phone number on the skip, and record the date and time. Report it to your council’s highways team. You are not liable for a skip placed without your knowledge, but acting quickly protects your position.

Some councils operate a tacit consent rule: if the council does not respond to a permit application within a set period (up to 21 days in some areas), the permit is treated as granted by default. Check whether your council applies this before assuming silence means approval.


The laws and official guidance to check

  • Highways Act 1980, section 139: the primary statutory basis for skip permits and enforcement on the public highway
  • Builders Skips (Markings) Regulations 1984: sets out the marking, lighting, and identification requirements for every skip on a highway
  • GOV.UK skip licence guidance: the starting point for finding your council’s application process and fees
  • Your local council’s highways or licensing pages: the definitive source for local fees, notice periods, and application forms

Councils rely on these documents when granting or refusing permits. If a council refuses your application or imposes conditions you believe are unreasonable, you can request the reasons in writing and cite the relevant sections of the Highways Act when challenging the decision. The GOV.UK page and your council’s own published policy are the documents to reference in any written challenge.


Lawful alternatives when you cannot place a skip on the highway

A permit refusal or an unsuitable road does not have to stop the project.

  • Place the skip entirely on private land. If a neighbour has a driveway or forecourt accessible to the skip lorry, ask whether they will allow temporary use. Get written permission, confirm the dates, and check whether their property insurer needs to be notified.
  • Wait-and-load service. The lorry arrives, you load it on the spot, and it leaves. No highway time, no permit. Best for smaller clear-outs where you can have everything ready before the lorry arrives.
  • Bagged waste collections. Builders’ bags (typically one cubic metre) can be placed on private land and collected by licensed carriers. Slower for large volumes but useful where access is tight.
  • Roll-on roll-off containers on private land. For larger projects, a roll-on roll-off container positioned within a site boundary avoids the highway entirely. Requires adequate access width for the delivery vehicle.
  • Licensed waste transfer stations. Hire a van or trailer and take waste directly to a licensed transfer station. Cheapest per tonne for small volumes; time-intensive for larger projects.

For any arrangement involving a neighbour’s land, a brief written agreement covering dates, access times, and liability is worth drafting before the skip arrives.


A practitioner’s view on managing skips during home works

The permit window is the detail most homeowners underestimate. A skip sitting on the road for three days past its permit expiry is an unauthorised obstruction, regardless of whether the build is still running. Book the permit to cover the full expected duration of the works, not just the first week, and build in a few extra days as a buffer.

Keep a printed copy of the permit number with whoever is managing the site day to day. Enforcement officers do not always give advance warning, and a site foreman who cannot produce the permit reference on the spot creates unnecessary delays. The same applies to waste transfer notes: ask contractors to hand them back before they leave site, not weeks later when the paperwork trail has gone cold.

When getting quotes for extension work, ask builders to include the skip permit cost as a named line item. A fixed quote that buries permit costs in a contingency figure is harder to audit if costs overrun. The planning permission drawings guide covers the documentation side of extension projects in similar detail.


Planning a home extension? The Extension Works handles the hard parts

Skips are one of the less glamorous realities of a rear extension build, but they are rarely the most complex part. The Extension Works offers a fixed-price, fully managed service for single-storey rear extensions in Sutton, Morden, and surrounding areas, covering everything from instant online quotes and live 3D modelling through to planning permission, structural calculations, and construction.

The Extension Works

Every project is handled by an in-house team, which means one point of contact from first sketch to final sign-off, a 12-month workmanship warranty, and a VAT-inclusive price with no hidden contingencies. For homeowners who have just worked through the permit and compliance checklist above, handing the entire build to a single managed service removes a significant layer of coordination. Get an instant quote at Theextensionworks to see a fixed price for your project.

This article is general information, not a substitute for advice from a qualified lawyer. Consult a qualified legal professional about your own circumstances before acting on anything here.
